Four Week Look Ahead Schedule in Primavera P6: How to Build a Lookahead Filter in Primavera P6

Creating Four Week Look Ahead Schedule In P6 Figure 1

How to Build a Lookahead Filter in Primavera P6?

If you wanna learn how to create a four-week look-ahead schedule using Primavera P6, we will tell you below. And we will look at Four Week Look Ahead. Then, we will go over how to use a 4-week look-ahead template in Excel.

Crafting a Four Week Look Ahead Schedule in Primavera P6

You can try to imagine trying to manage a hundred ping pong balls at once. That’s what managing a construction project can feel like.

Grouping and Sorting Activities

Next, you will want to group and sort your activities to make the schedule easy to follow. You can organize them by date, make a note of any critical activities and mark potential risks. This is like organizing your closet such as organizing neat stacks make it easy to find.

Updating the Schedule

Weekly check-ins will become your new best friend. But do not forget to communicate these updates to your team. This will make everyone is on the same page.

Why Four Week Look Ahead primavera is Crucial for Your Project’s Success

A Four Week Look Ahead Schedule in Primavera P6 is not just a piece of document. It is your roadmap for project management. This scheduling technique allows project managers to preview short-term tasks and milestones.

Four Week Look Ahead Schedule In Primavera P6:

The Lookahead Filter Magic

Primavera P6 takes project scheduling to the next level with this filter magic. These powerful filters create detailed project schedules while highlighting tasks and activities that need immediate attention. It’s like having a digital project manager constantly keeping an eye on your deadlines with look ahead schedule template.

While the focus of this guide is on mastering the four-week look ahead, the concept of a 90 days look ahead schedule cannot be overlooked. Hence, you will have both short-term and long-term planning horizons. So, it will be easy to can achieve a balance between immediate and longer term targets.

Four Week Look Ahead Schedule

For better understanding, let’s review a sample construction work schedule.

Figure 1 below shows a sample project of building 14 Block Valve Stations.

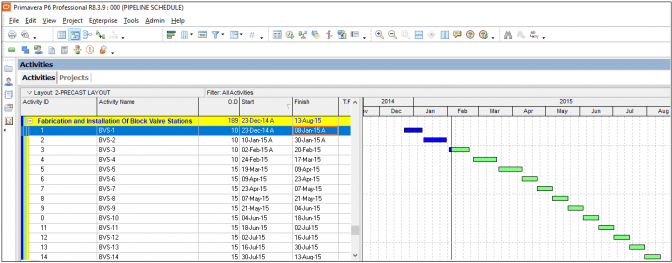

Creating Four Week Look Ahead Schedule In P6 Figure 1 1
Figure 1 – Creating Four Week Look Ahead Schedule In P6

As shown in Figure 1, Data Date (Blue Line) 04 Feb 2015 and there is no actual in the project. To create a filter Select View | Filter By from the main drop-down menu.

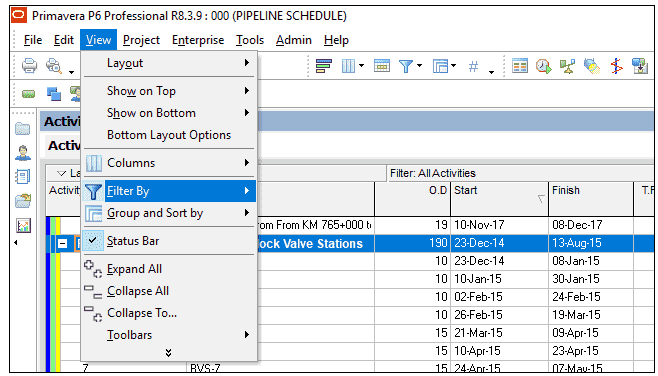

Creating Four Week Look Ahead Schedule In P6 Figure 2
Figure 2 – Creating Four Week Look Ahead Schedule In P6

This brings up the filter window, Figure 3.

Creating Four Week Look Ahead Schedule In P6 Figure 3 1
Figure 3 – Creating Four Week Look Ahead Schedule In P6

In the filter window, Default filters comes standard with P6. Global filters created by the system administrator. User Defined filters are created by the users. Now we will create a user defined filter, so in the User Defined section, select + New. (Figure 4)

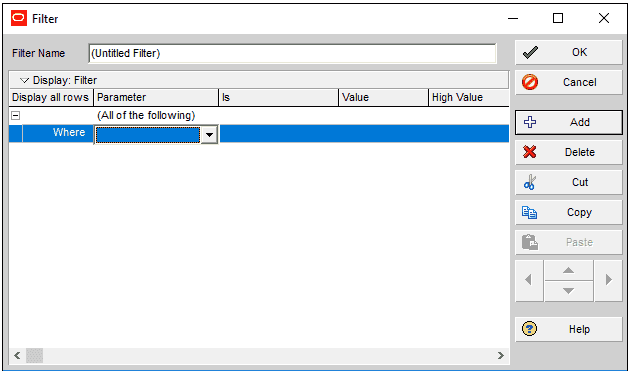

Creating Four Week Look Ahead Schedule In P6 Figure 4
Figure 4 – Creating Four Week Look Ahead Schedule In P6

Now we want to demonstrate all activities that start in the next four weeks. So the first line is Start is within range of DD DD+4W (DD is Data Date).
We also want to demonstrate the activities which started before the data date and in progress. Therefore the second line will be  Activity Status equals In Progress as shown in the Figure 5.

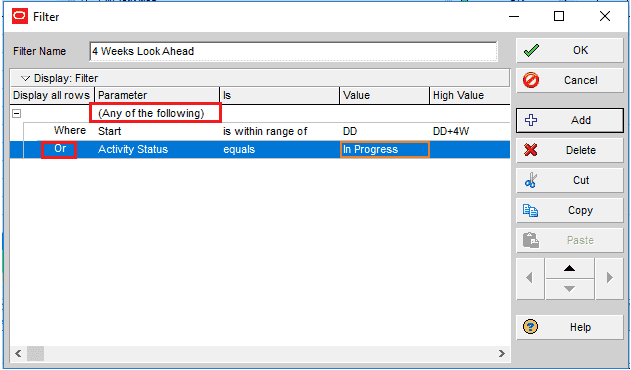

Creating Four Week Look Ahead Schedule In P6 Figure 5
Figure 5 – Creating Four Week Look Ahead Schedule In P6

When the parameter is Any of the following an ‘Or’ is placed between the first and second lines of the code. Conversely, if the parameter is All of the following an And is used. This implies that both lines of code must be true for the activity to be displayed.

Now, our code showcases all activities that either commence within the next four weeks or are currently in progress (Figure 6).

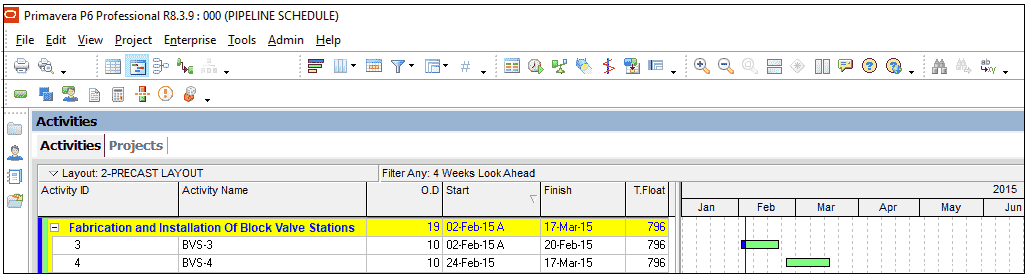

Creating Four Week Look Ahead Schedule In P6 Figure 6
Figure 6 – Creating Four Week Look Ahead Schedule In P6

As shown in the Figure 6, BVS -4 will start in the next four weeks and BVS-3 is in progress.

What is a 4-week look-ahead construction schedule?

A 4-week look-ahead construction schedule is a strategic tool used in project management to outline tasks and activities. And it is highlighting immediate priorities and helping managers to effectively allocate resources.

For example, using a 4 week look ahead template excel, a project manager can quickly identify which subcontractors need to be on-site in the forthcoming weeks. For 6 weeks one, you should select Start under Dates and set the parameter to is within the next 6 weeks.

What is a look-ahead schedule in Primavera?

This schedule filters the project schedule to only display activities that are due to start or finish within a specified short-term period. Such as the next 3, 4 or 6 weeks.

Thus it is enabling better decision-making and resource management. For instance, by applying a Primavera lookahead filter, project managers can isolate tasks for the upcoming phase. In the Activities tab and Tools menu, first you should find and select Schedule. And it is easy to set data date to reflect the current review date.

What is a 4-week project timeline?

Using a 4 week look ahead template excel can help project managers to visualize this timeline.

What is a 3-week look ahead schedule?

A 3-week look ahead schedule is similar to 4-week counterpart. But it focuses on the immediate three-week window of the project schedule.

How do I create a look ahead filter in Primavera P6?

Creating a look-ahead filter in Primavera P6 enables project managers to concentrate on forthcoming tasks.

  1. In the Activities window, you will click on the Filter icon to access filters and select 3 Week Look Ahead.
  2. For the filter criteria, you should select Start Date and configure it to show activities starting is within the next 3 weeks.
  3. Lastly, you will save and apply this filter.

What is a look-ahead schedule (90 days look ahead schedule)?

A look-ahead schedule focuses specifically on short-term project activities. It is usually spanning a 2 to 6-week period. Also, whether through a 90 days look ahead schedule for broader planning or a more immediate 3 week look ahead, these schedules are vital for maintaining project momentum.

How do I organize my Primavera activities?

Organizing activities in Primavera P6 requires a systematic approach. You can use the Work Breakdown Structure (WBS) for hierarchical organization, apply activity codes for categorizing tasks and apply Group and Sort feature to arrange activities in a logical order.

Lookahead Filter in Primavera P6

1: Open Your Project

First, you should launch Primavera P6 and open the project.

2: Finding Filters Section

  • Once your project is open, go to the Activities tab.
  • Then, you should look for the Filters icon or option. It is typically located in the toolbar at the top or under the View menu.

3: Create a New Filter

  • Then, you should click on Filters and then select Manage Filters and Add.

4: Define Your Filter Criteria

  • You should name your filter something easy like 4 Week Look Ahead or 3 Week Look Ahead.
  • Now, you will set up the criteria that define your lookahead period. Also, you can use a combination of criteria. But the most common approach is to filter based on the Start or Finish.
  • For a lookahead filter, you need to select Start or Finish under the Parameter column, then choose – is within range from the Operator dropdown.
  • In the Value field, you will define the lookahead time frame. For a 4 week look ahead, you might set it to DD/Mon/YYYY and DD+28/Mon/YYYY.

5: Refine Your Filter (Optional)

  • You might want to add more criteria to refine your filter further. For example, you could add a criterion to exclude completed tasks by setting Status to not Equal to and Completed.
  • Use the And/Or column to specify how multiple criteria should work together.

6: Save and Apply Your Filter

  • Once you have set up your criteria, you should click OK to save your filter.
  • Back in the Activities view, you will apply your newly created filter by selecting it from the Filters dropdown menu.

7: Adjust and Update as Needed

Just a heads up: project schedules are always changing. You will probably need to edit your lookahead filter as your project moves along. It is a good idea to update it regularly to match the current project date or to adjust for any changes.

This helps make sure that important tasks get the attention they need.

Summary

Primavera P6 filters is a practical tool for the schedulers. It enables the use all kinds of filters for reporting and scheduling purposes. Also, it is important to know the functions of All of the following and Any of the following parameters. Another key point is to understand the function of a look-ahead schedule.

With Primavera P6, you’re not just managing tasks, you will be mastering them. Also, you can Download a lookahead schedule template and check some tutorials.
